Driveway Installation: Getting the Foundations Right From the Start

By Housey · Last reviewed 31st of May 2026

Diagram illustrating: Driveway Installation: Getting the Foundations Right From the Start

Driveway Installation: Getting the Foundations Right From the Start

The decision to install or replace a driveway is one of the most common improvement projects for UK homeowners, often prompted by a crumbling tarmac surface, an expanding household with additional vehicles, or a desire to improve kerb appeal ahead of a sale. The finished surface gets most of the attention in quotes and showroom visits, but the sub-base depth and drainage design determine whether a new driveway lasts five years or twenty-five. A handful of planning and drainage requirements introduced since 2008 also catch homeowners off guard before work has even begun.

Key points

  • Driveways over 5 m² using an impermeable surface require planning permission in England unless surface water drains to a lawn, flower bed, or permeable soakaway within the property — a rule introduced by the Town and Country Planning (General Permitted Development) Order 2008.
  • A correctly specified domestic driveway sub-base typically requires 100–150 mm of compacted Type 1 MOT granular material on a geotextile membrane, increasing to 150 mm or more on clay soils.
  • Block paving, resin-bound aggregate, and gravel are all classified as permeable surfaces when correctly specified, generally avoiding the planning permission requirement.
  • Surface water from a driveway must not discharge onto the public highway — a requirement under the Highways Act 1980 that applies regardless of surface material or driveway size.
  • VAT on residential driveway installation is charged at the standard rate of 20%; zero-rating may apply for new-builds or installations for a disabled person's principal home — always confirm the applicable rate with your contractor before signing a contract.

Do I need planning permission for a new driveway?

Since October 2008, the Town and Country Planning (General Permitted Development) Order has removed Permitted Development rights for front garden driveways larger than 5 m² using a non-permeable surface, unless surface water drains to a lawn, flower bed, or suitable soakaway within the property.

In practice:

  • Permeable surfaces (resin-bound aggregate, permeable block paving with open jointing, gravel laid on free-draining sub-base): generally do not require planning permission.
  • Impermeable surfaces (standard tarmac, solid concrete, traditionally mortared block paving) where run-off drains to a lawn or soakaway within the property: generally do not require planning permission.
  • Impermeable surfaces where run-off discharges to highway drainage: planning permission required.

Rules differ in Wales, Scotland, and Northern Ireland — check with your local planning authority. Conservation areas and listed buildings may face additional constraints regardless of surface type.

Do you need planning permission? — decision tree

  • Is the driveway at the rear of the house? → Planning permission unlikely required for most surfacing works.
  • Is the surface permeable (resin-bound, gravel, permeable block paving)? → Planning permission generally not required in England.
  • Does surface water drain to a lawn or flower bed within the property boundary? → Planning permission generally not required.
  • Is the property in a conservation area, or is it listed? → Check with your local planning authority before starting any work.
  • None of the above apply? → Contact your local planning authority; a Householder Application may be needed.

Always verify with your local planning authority, as property history and local conditions can affect the outcome.

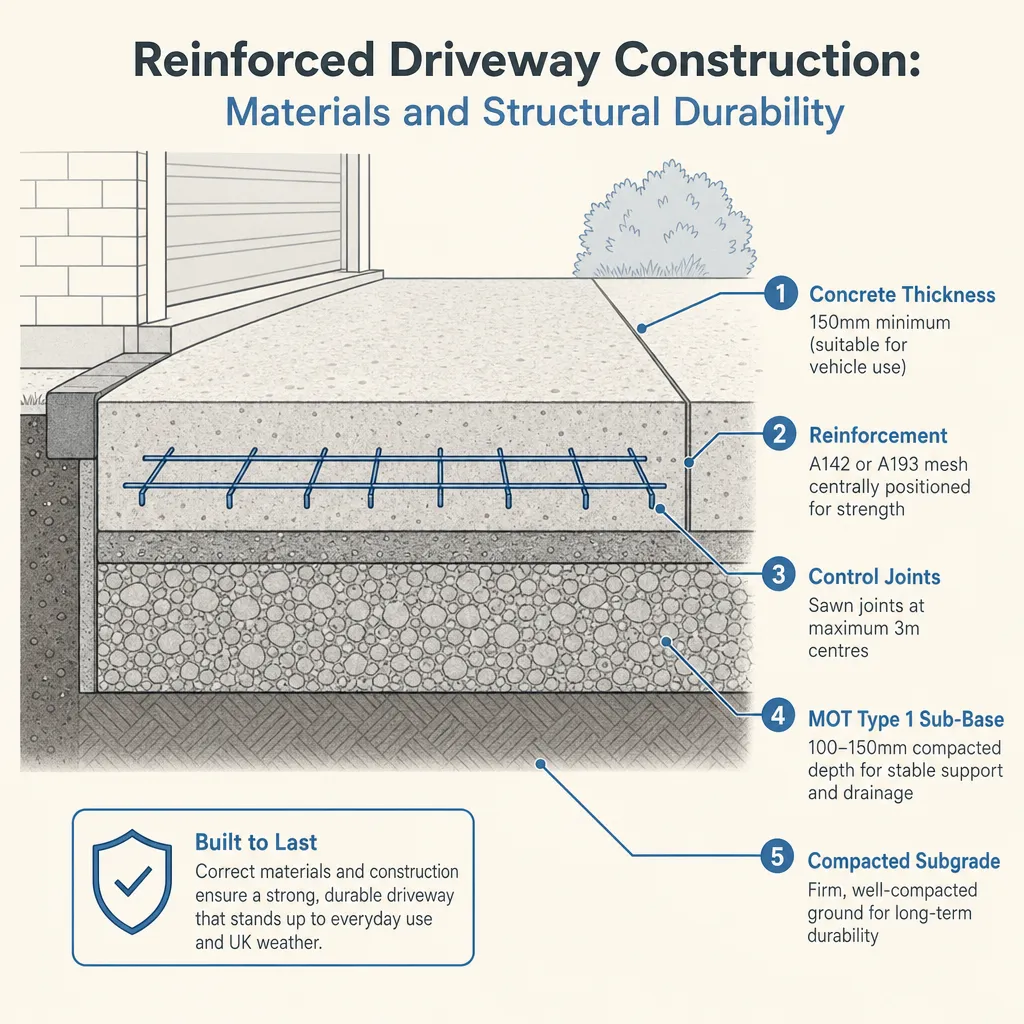

Sub-base preparation: why what lies beneath matters most

The sub-base is the structural foundation that distributes vehicle loads across the ground beneath. Most driveway failures — cracking, rutting, settlement, and edging movement — originate from inadequate sub-base depth or poor preparation, not from the quality of the surface material itself.

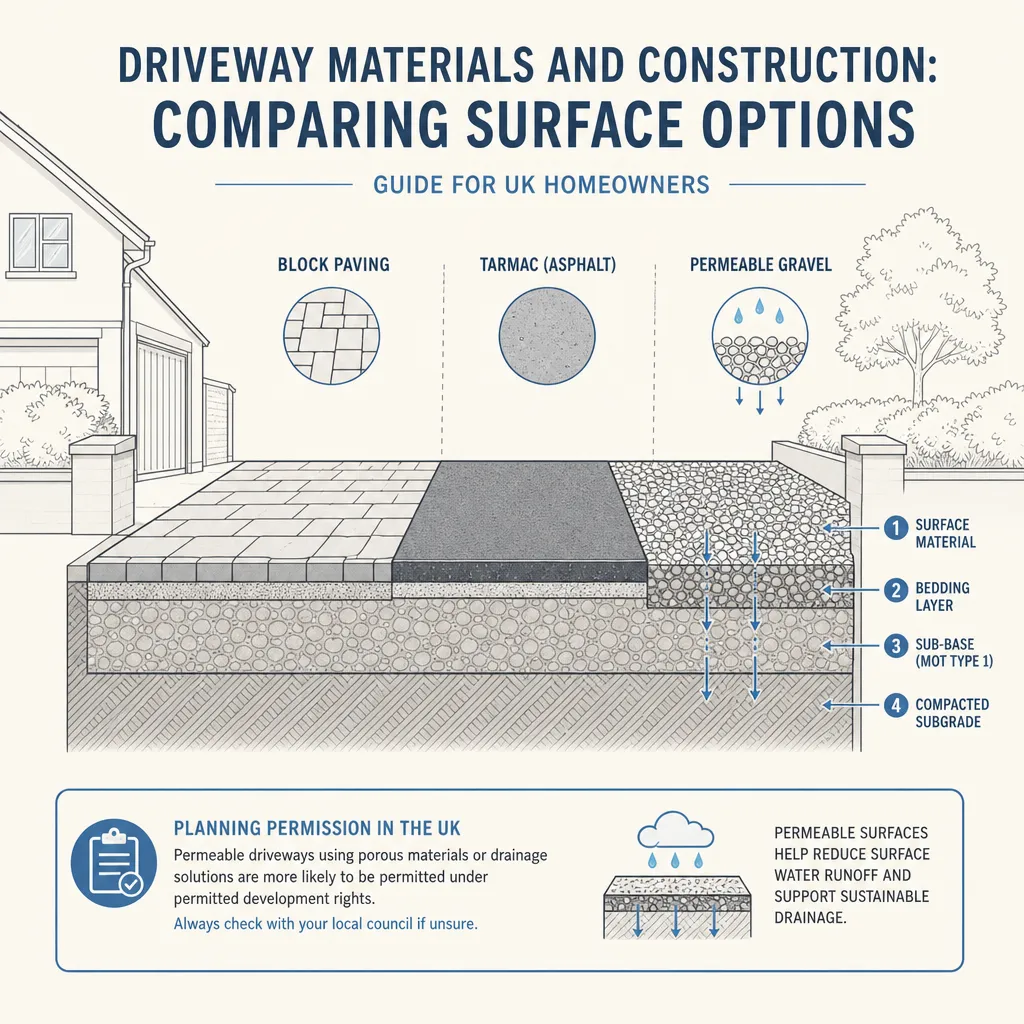

A standard sub-base sequence for a residential driveway:

  1. Excavate to the required total depth — typically 200–300 mm depending on surface type and ground conditions
  2. Lay a geotextile membrane over the prepared formation to prevent sub-base and subgrade intermixing over time
  3. Place and compact Type 1 MOT granular sub-base to a minimum of 100 mm on firm ground, or 150 mm or more on clay or soft ground
  4. Install edge restraints — concrete haunching or proprietary plastic edging — before laying the surface to prevent lateral spread

On clay soils, present across large parts of England, seasonal shrink-swell movement can cause differential settlement beneath a driveway. Experienced contractors working in these areas often increase sub-base depth or add a lean-mix concrete layer as a precaution. A poorly prepared sub-base on clay is by far the most common cause of premature surface failure within three to five years of installation.

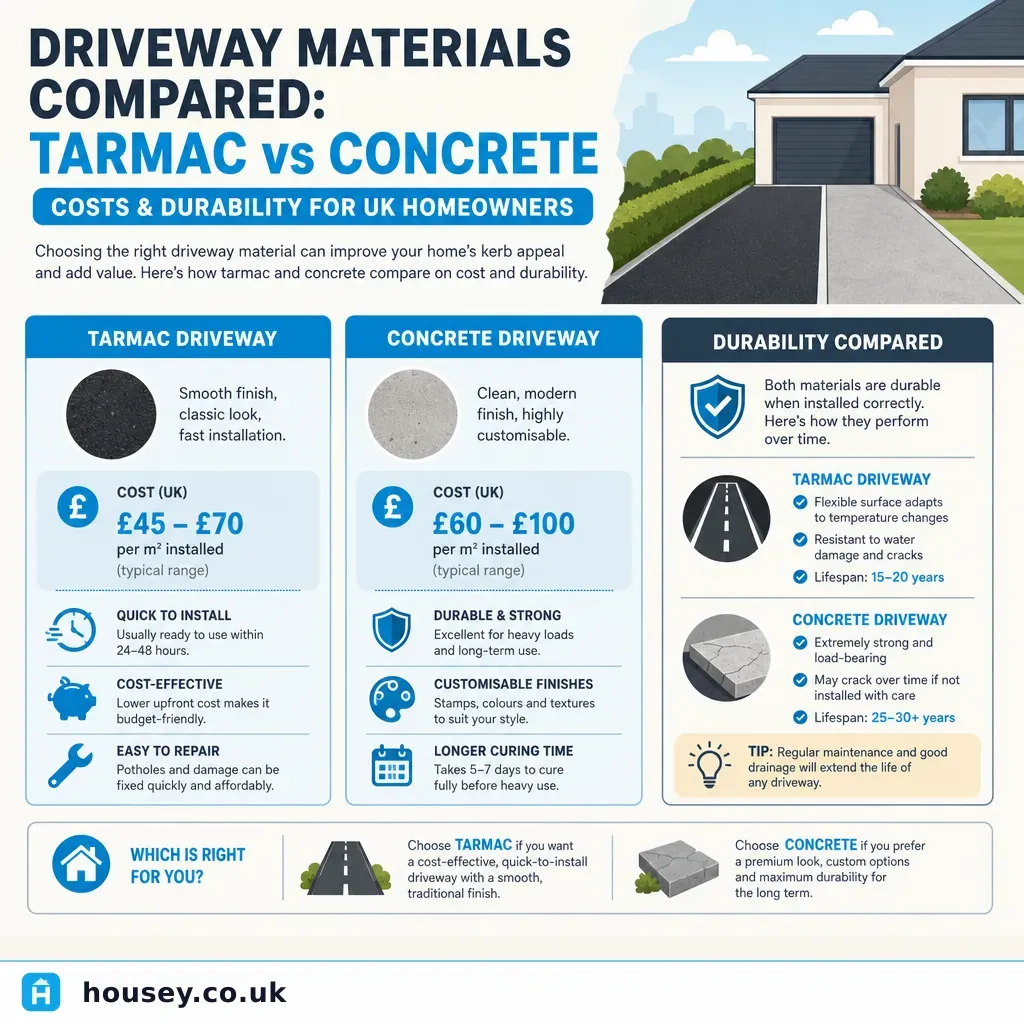

Comparing driveway surface materials

Material

Typical lifespan

Permeable?

Relative cost

Best for

Not ideal for

Tarmac (asphalt)

15–25 years

No (standard)

£

Large areas; fast installation; robust in cold weather

Front gardens over 5 m² (planning permission may apply); surface can soften in extreme heat

Block paving

20–30+ years

Yes, if open-jointed

££

Appearance; long-term durability; individual blocks replaceable

Higher installation cost; needs correct sub-base depth on clay soils

Resin-bound aggregate

15–25 years

Yes (fully permeable)

££–£££

Smooth decorative finish; weed-resistant; no planning permission needed

Requires skilled installation; surface can crack if sub-base fails

Concrete

25–40 years

No (standard)

££

Durability; heavy vehicle use; low long-term maintenance

Planning permission often required; difficult to repair if cracked; expansion joints essential

Gravel (loose)

5–15 years

Yes

£

Low cost; quick installation; fully permeable

Displacement under tyres; weed growth; maintenance-intensive; unsuitable for steep slopes

Porcelain / natural stone

25+ years

Depends on jointing

£££

Premium appearance; durable surface

High material and installation cost; must be jointed permeably for Permitted Development compliance

Indicative UK costs, last reviewed 2026-05-31. Prices vary by region, driveway size, ground conditions, and contractor. Always obtain written quotes.

Drainage: the rule that catches homeowners out

Drainage design is where planning compliance, practical installation, and legal obligation converge. The key principles for UK homeowners:

  • Surface water must not run onto the public highway — a requirement under the Highways Act 1980 that applies regardless of driveway material or size.
  • Water should be directed to a soakaway, permeable area, or drain within the property boundary.
  • If connecting to an existing surface water drain, check whether your local authority or water company requires approval — requirements vary across authorities and water companies.
  • In Wales, Schedule 3 of the Flood and Water Management Act 2010 (in force since January 2019) requires Sustainable Drainage Systems (SuDS) approval from the local SuDS Approving Body (SAB) for new drainage above a certain area — check early in the design process.
  • In England, Schedule 3 SuDS provisions are planned but not yet in force nationally — monitor GOV.UK guidance for updates before commencing works.

Checklist: what to confirm before your driveway installation starts

Use this checklist when reviewing contractor proposals and preparing your property:

What to ask before accepting a quote

  • What excavation depth and sub-base specification are you proposing, and why?
  • Is disposal of excavated material (spoil) included in the quoted price?
  • What drainage solution are you proposing, and how does it comply with Permitted Development requirements?
  • Are edge restraints included, and what type?
  • What surface product are you specifying — supplier, grade, and specification?
  • What guarantee does the completed installation carry, and is it in writing?
  • Is VAT included, and at what rate?
  • Are you registered with TrustMark or a member of a recognised trade body such as the British Association of Landscape Industries?
  • What is your programme, and how long will the driveway be out of use?

When to get professional help

Most driveway installations are straightforward home improvement projects, but seek specialist advice before proceeding if:

  • The property is in a conservation area or is a listed building
  • Trees are present within or adjacent to the work area — roots can be damaged by excavation, and Tree Preservation Orders (TPOs) may restrict certain works
  • Ground conditions are poor — boggy ground, soft clay, or suspected made-ground or fill material
  • You need to create or alter a dropped kerb to the public highway — this requires consent from the local highway authority and work on the highway must be carried out by an approved contractor
  • The proposed driveway drains towards a neighbouring boundary or a watercourse

How Housey can help

Housey connects homeowners with vetted driveway installers across the UK. Whether you are replacing a tired tarmac surface or laying a new resin-bound driveway from scratch, you can request and compare written quotes from local specialists who understand your area's ground conditions, drainage requirements, and planning rules.

Frequently asked questions

Do I need planning permission for a new driveway?

In England, planning permission is generally not required if the surface is permeable (gravel, resin-bound, permeable block paving) or if an impermeable surface drains to a lawn or soakaway within the property boundary. Driveways over 5 m² with impermeable surfaces discharging to highway drains do require a Householder Application. Rules differ in Wales, Scotland, and Northern Ireland — always check with your local planning authority before starting work.

How long does a new driveway last?

A well-constructed concrete driveway can last 25–40 years; block paving 20–30+ years; tarmac and resin-bound typically 15–25 years; gravel requires regular topping up over a 5–15 year lifespan. Longevity depends heavily on sub-base quality, drainage design, ground conditions, and the weight and frequency of vehicles using the surface. A poor sub-base on clay soil is the most common cause of early failure.

How thick should the driveway sub-base be?

For a typical domestic driveway on firm ground, a compacted Type 1 MOT sub-base of 100 mm minimum is standard. On clay soils or where heavier vehicles such as vans or motorhomes are parked regularly, 150 mm or more is commonly specified. Total excavation depth also includes the bedding layer (around 30–50 mm for block paving) and the surface material itself. Ask your contractor to specify all depths in writing before work begins.

Do I need a dropped kerb for a new driveway?

If no vehicle crossing currently exists at the boundary with the public highway, you need consent from your local highway authority before creating one. Work on the public highway must normally be carried out by an approved contractor. Driving over an unmodified kerb can cause damage and create legal liability. Contact your local authority's highways department early in the planning process, as lead times can extend to several months.

Is driveway installation subject to VAT?

Standard VAT at 20% applies to most residential driveway installations. Zero-rating may apply for new-build properties or for installations carried out for a disabled person's principal home under the VAT Act 1994. Always ask your contractor to confirm the applicable VAT rate and show it clearly on the written quote, as errors can be costly to correct once works have started.
